11. Load production and capacity data¶
Supply Planning can propose production only when it knows where to produce, which resources to consume, how much time to use, and which components to transform. These relationships are master data; they are not production orders.
How the objects connect¶
flowchart LR
ML[Output material + location] --> PV[Production version]
PV --> RT[Production routing]
RT --> OP1[Operation 10: machine]
RT --> OP2[Operation 20: labor]
OP1 --> RM[Machine resource]
OP2 --> RL[Labor resource]
RM --> AM[Daily availability]
RL --> AL[Daily availability]
PV --> BOM[Bill of materials / recipe]
BOM --> CP[Components]
CP --> MI[Input materials]
Transportation is intentionally absent from this diagram; the next chapter covers the supply network separately.
Load sequence¶
- Production Resources;
- Production Resource Availability;
- Production Routing;
- Production Routing Operations;
- Bill of Materials;
- Bill of Materials Components;
- Single-routing Production Version.
Routing and bill of materials form independent branches. Load the production version only after both branches exist.
Tutorial files¶
Download one workbook per topic; each file keeps the exact header returned by the official Community endpoint.
01-production-resources.xlsx 02-production-resource-availability.xlsx 03-production-routing.xlsx 04-production-routing-operations.xlsx 05-bill-of-materials.xlsx 06-bill-of-materials-components.xlsx 07-production-version.xlsx
1. Open the production topics¶

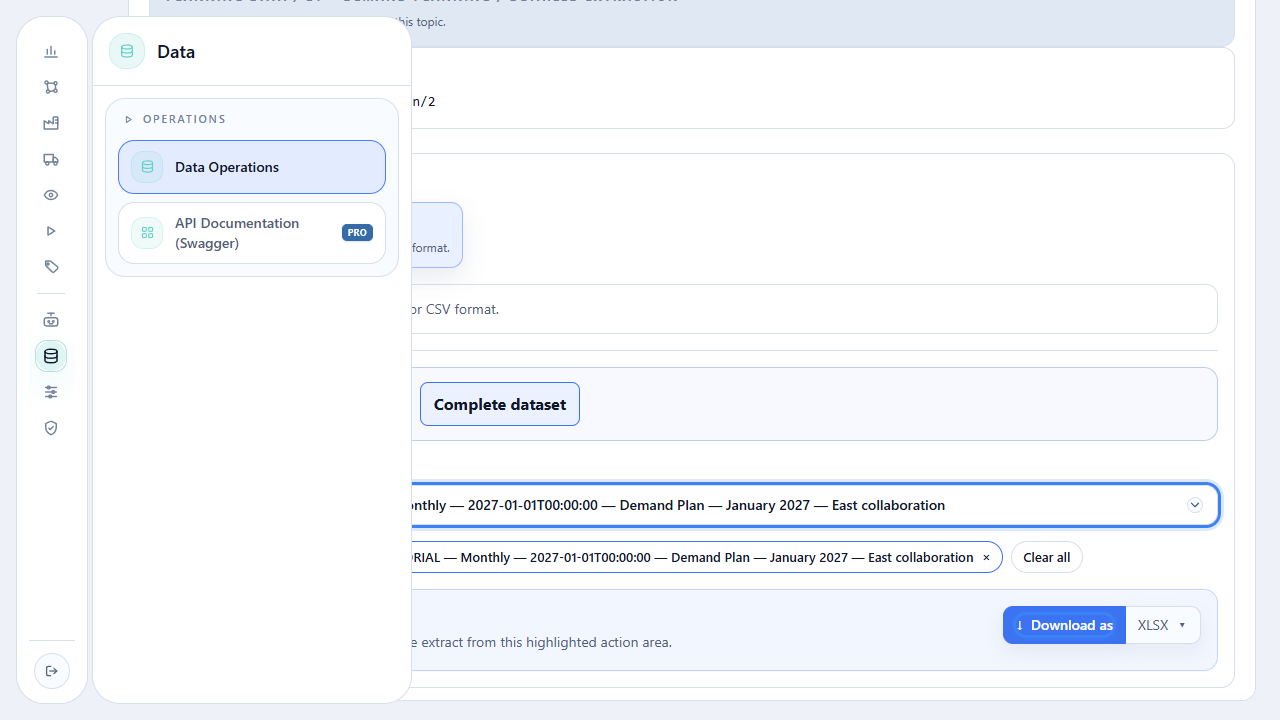

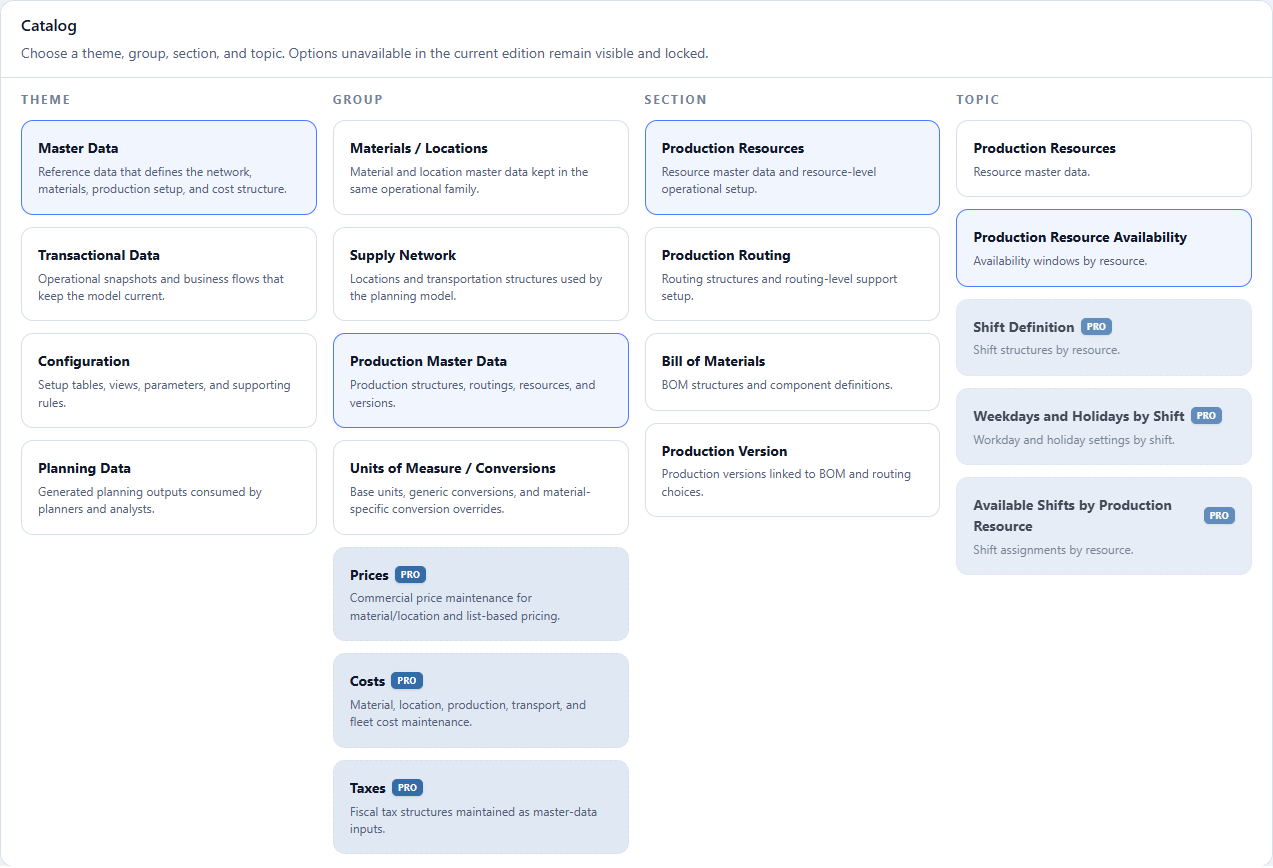

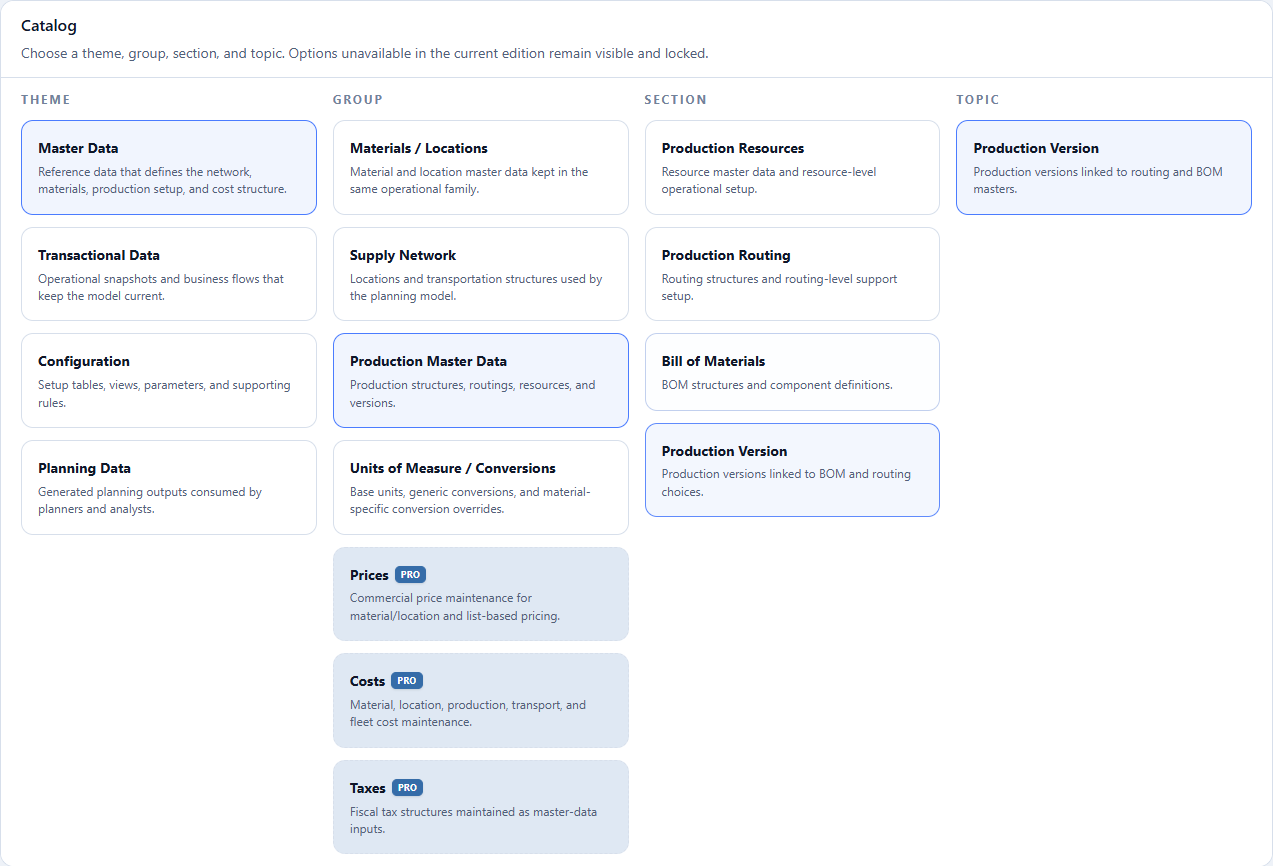

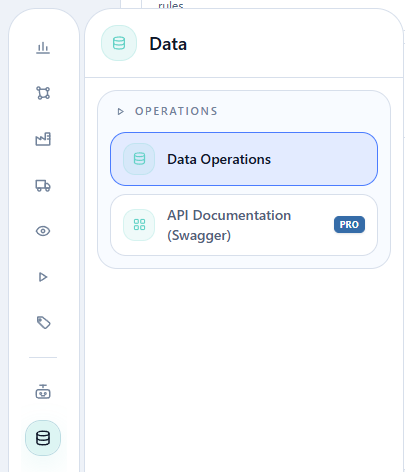

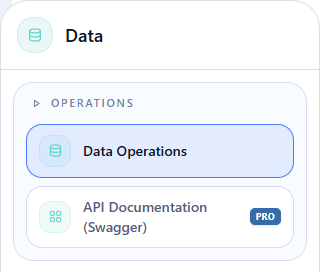

Hover over Data and open Operations > Data Operations.

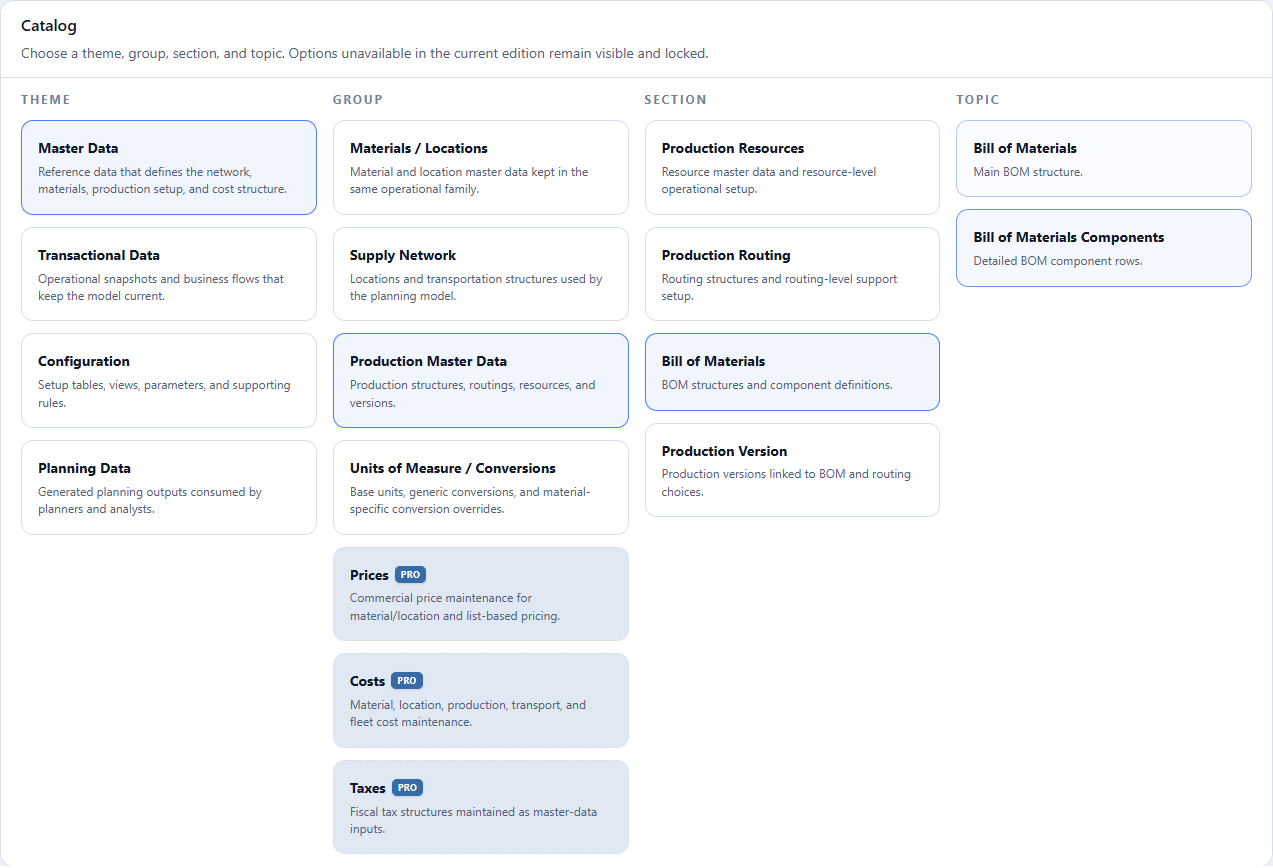

In the catalog, follow Master Data > Production Master Data and select each topic in the sequence above.

2. Register resources and availability¶
Use separate resources for machine and labor:

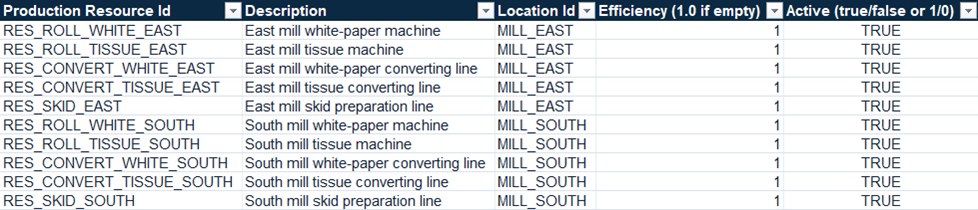

| Production Resource Id | Description | Location Id | Efficiency | Active |
|---|---|---|---|---|
RES_MACHINE_EAST |
East converting machine | MILL_EAST |
1 | true |
RES_LABOR_EAST |
East converting labor | MILL_EAST |
1 | true |
Availability uses one row per resource per day. A missing date means zero available hours, so load every working day in the horizon rather than one monthly row.
The reconciled tutorial dataset contains 261 weekdays for each resource: 522 availability rows from January through December 2027.
| Production Resource Id | Reference Date | Available Hours |
|---|---|---|
RES_MACHINE_EAST |
2027-01-04 |
16 |
RES_LABOR_EAST |
2027-01-04 |
16 |
Action to perform

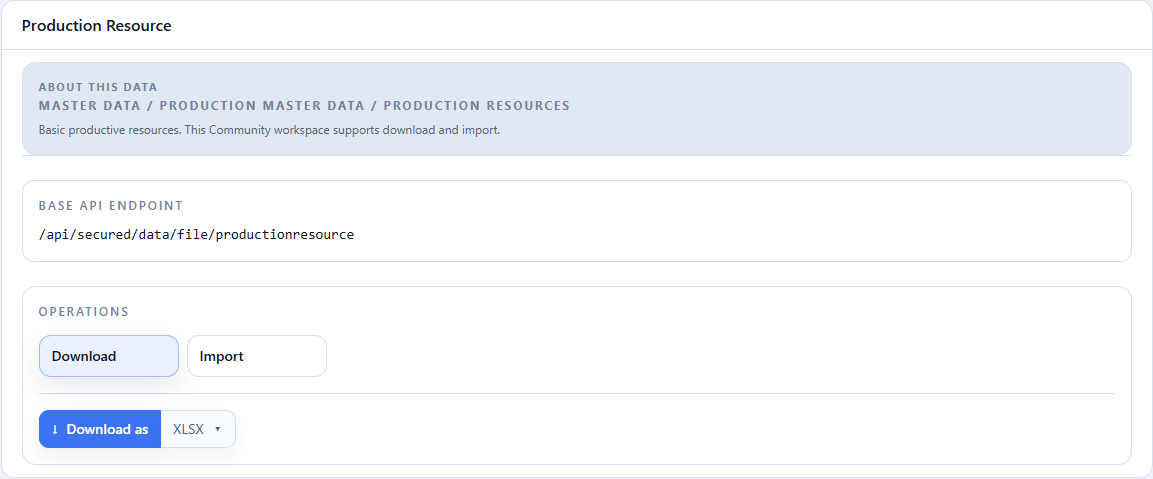

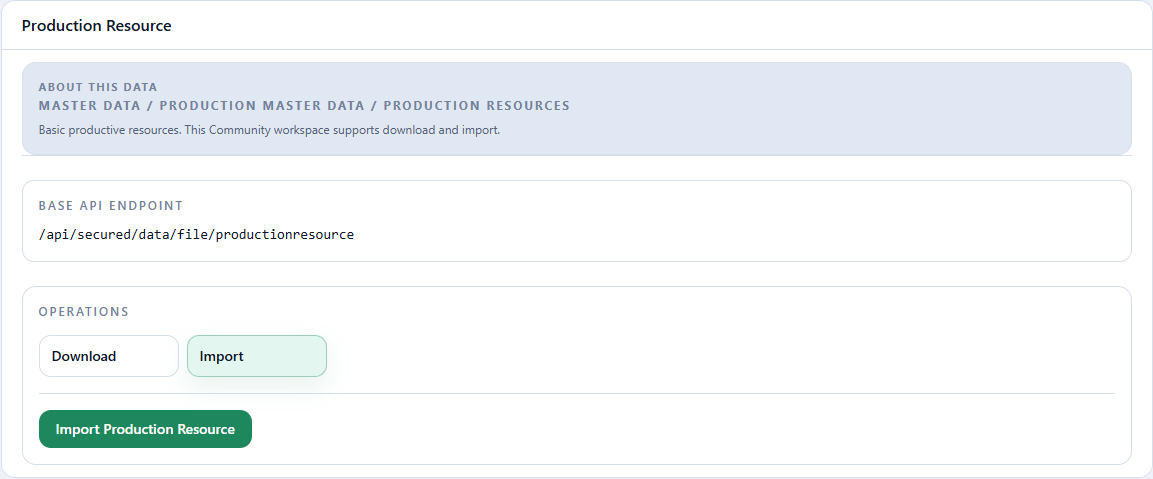

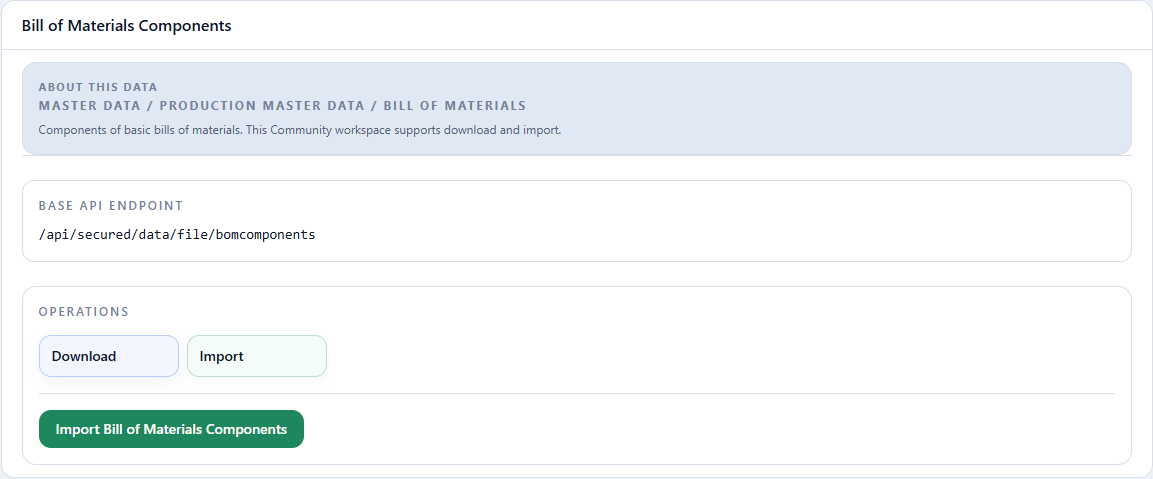

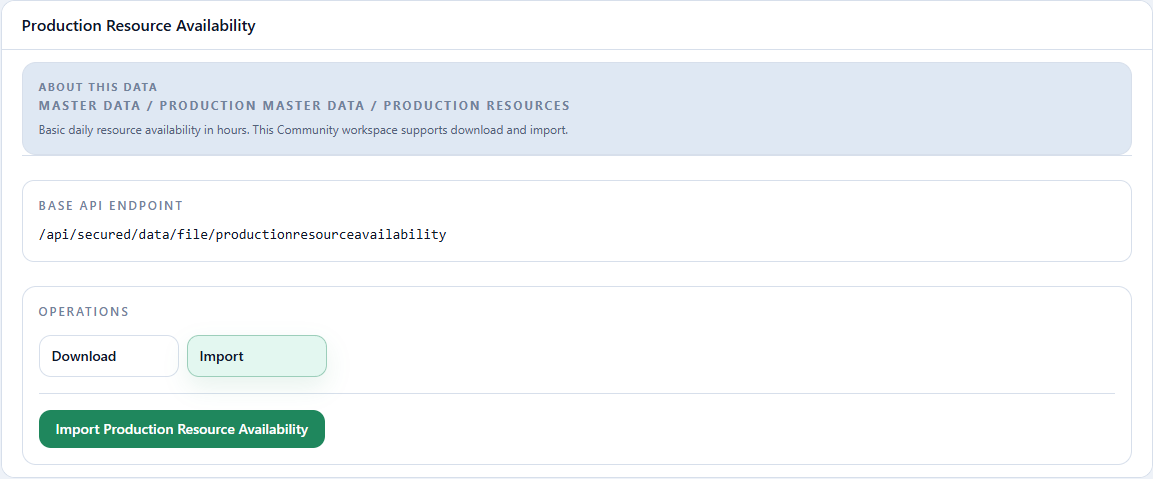

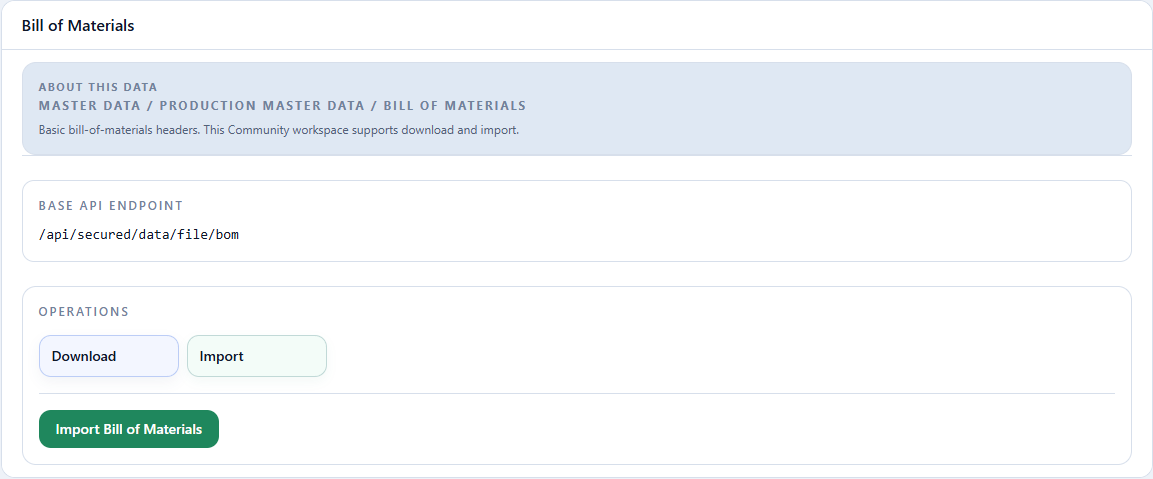

In each topic, click Download to obtain the template, fill the published columns, and use Import. Confirm the success message before moving to a dependent topic.

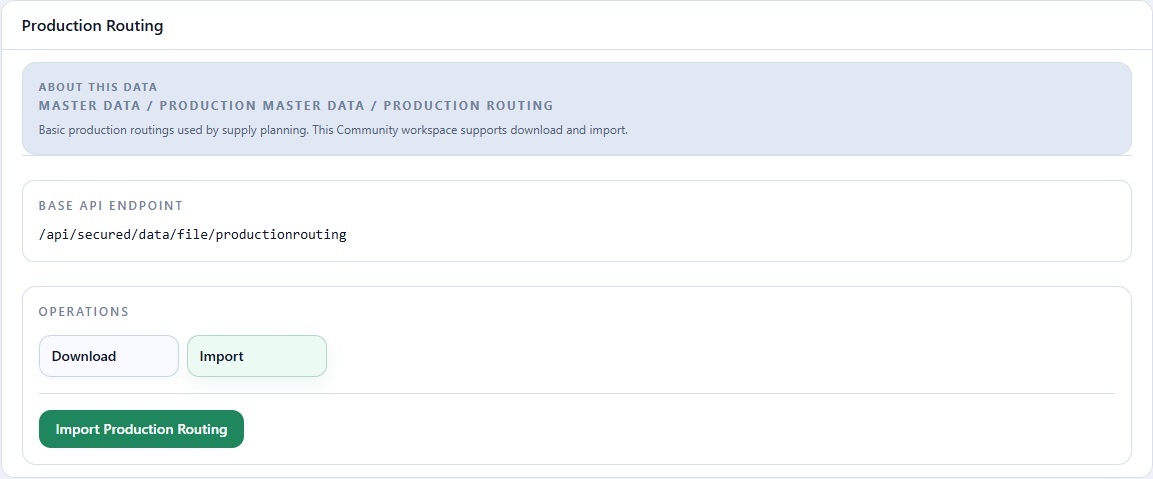

3. Create the routing and two operations¶
The routing identifies the output material and plant. Each operation points to one resource, so machine and labor are separate operations.
| Routing Id | Location Id | Output Material Id | Priority | Active |
|---|---|---|---|---|
ROUTE_TISSUE_DOUBLE_EAST |
MILL_EAST |
FG_TISSUE_DOUBLE_12 |
0 | true |
| Routing Id | Operation Sequence | Production Resource Id | Base Quantity | Base Quantity UOM | Hours by Base Quantity |
|---|---|---|---|---|---|
ROUTE_TISSUE_DOUBLE_EAST |
10 | RES_MACHINE_EAST |
1 | TON |
1.25 |
ROUTE_TISSUE_DOUBLE_EAST |
20 | RES_LABOR_EAST |
1 | TON |
0.80 |
The engine constrains capacity by resource. Production duration uses the largest operation time; do not describe this as detailed scheduling or shift synchronization.

4. Create the bill of materials and components¶

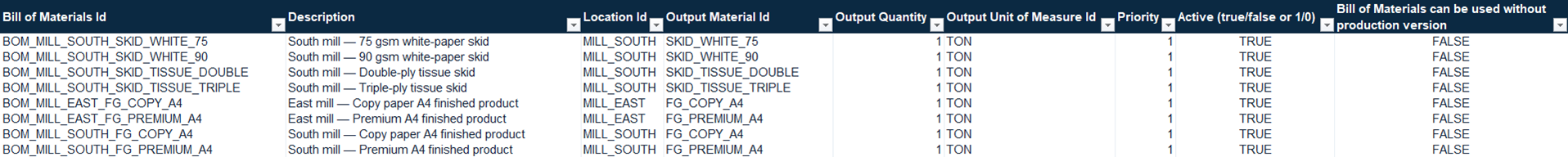

| Bill of Materials Id | Location Id | Output Material Id | Output Quantity | Output Unit of Measure Id | Priority | Active |
|---|---|---|---|---|---|---|
BOM_TISSUE_DOUBLE_EAST |
MILL_EAST |
FG_TISSUE_DOUBLE_12 |
1 | TON |
0 | true |

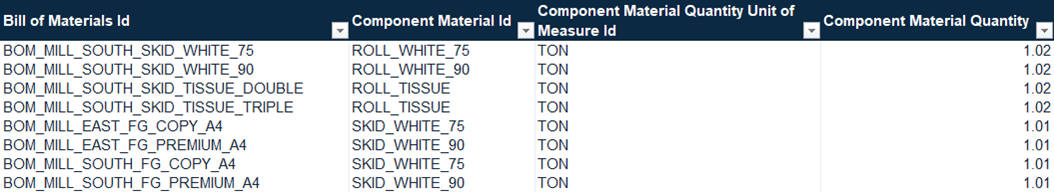

| Bill of Materials Id | Component Material Id | Component Material Quantity Unit of Measure Id | Component Material Quantity |
|---|---|---|---|
BOM_TISSUE_DOUBLE_EAST |
ROLL_TISSUE |
TON |
1.03 |
The 1.03 quantity represents technical consumption and physical loss in the
example; it is neither a cost nor an economic rate.
5. Link the routing and bill of materials¶

| Id | Location Id | Priority | Output Material Id | Routing Id | Bill of Materials Id | Active |
|---|---|---|---|---|---|---|
PV_TISSUE_DOUBLE_EAST |
MILL_EAST |
0 | FG_TISSUE_DOUBLE_12 |
ROUTE_TISSUE_DOUBLE_EAST |
BOM_TISSUE_DOUBLE_EAST |
true |
Action to perform
Import the version last. If it fails, reconcile the material, location, routing, and bill-of-materials IDs; do not create a silent fallback.
Completion criterion¶
Every resource, availability day, routing, operation, bill of materials, component, and version must import without errors and use a consistent location and unit.
Return to Demand Plan review, or continue with the supply network.
